Factory-Direct · Huangyan, China
Injection Moulding in China
Plastic injection molding in China pays off once your order volume reaches 3,000 to 10,000 pieces. Below that, the tooling is hard to earn back. Above it, piece prices drop fast. Topworks builds the molds and runs the presses in Huangyan, so you buy from the factory, not a trading company. One contract covers DFM review, prototypes, tooling, production and delivery to your door.
Many overseas buyers overpay because a middleman pads the quote and farms the work out to a backstreet shop. We machine every mold we run in our own toolroom. That cuts your upfront cost and your lead time. You can also put multi-part assemblies or family molds on one purchase order. Each extra part then skips its own setup fee.
When Plastic Injection Molding in China Pays Off
Injection molding gives the lowest landed cost per unit once volume reaches 3,000 to 10,000 pieces. Steel tooling takes capital up front. Fast press cycles then push your piece price far below 3D printing or CNC. That gap is how consumer brands and industrial OEMs keep margins at scale.
3,000–10,000 pieces: Typical break-even volume where mold amortization beats machining or printing.
300–1,200 bar: Typical injection pressure range for dense, repeatable commercial parts.
180T –1800 T: Clamping force range across our 15 injection presses.
1 g – 10 kg: Part weight range we mold in production.
We mold automotive components, medical housings, household appliance parts and consumer goods. You get commodity and engineering resins with Pantone color matching. Common grades include ABS, polycarbonate, PA6 and PA66, PMMA and PPS. Not sure which one fits? Start with our plastic material selection guide.
Hollow bottle or tank? Compare budgets against our blow molded parts. Need a soft grip bonded to a rigid part? See our overmolding work, which removes a manual assembly step.
When to hold off on hard tooling: Below roughly 3,000 pieces, hard tooling rarely pays back. The same goes for a design that still changes every month. CNC or bridge tooling protects your cash better. See our low volume injection molding options. Send your target annual volume first and we will quote the most profitable path.
What Our Injection Molding Service in China Covers
Major vehicle and appliance brands rarely mold every plastic sub-assembly in-house. Subcontracting to a specialist frees your capital. You still keep tight control over fit and compliance.
Our China injection moulding service runs in three ways:
- New tool plus production. We design and build the mold, then run your parts on it. Tooling details sit on our injection mould tooling page.
- Production on your existing mold. Ship us the tool. We inspect it, refit it where needed and run a trial before production. Read our mold transfer checklist first.
- Molding plus finishing. Assembly, packaging and DDP shipping on one contract, with one team accountable.
When you send an RFQ, a project manager maps every milestone from steel order to T1 shipment. Tell us how the part installs and what heat or load it sees in the field. That context stops us quoting an over-engineered mold you do not need.

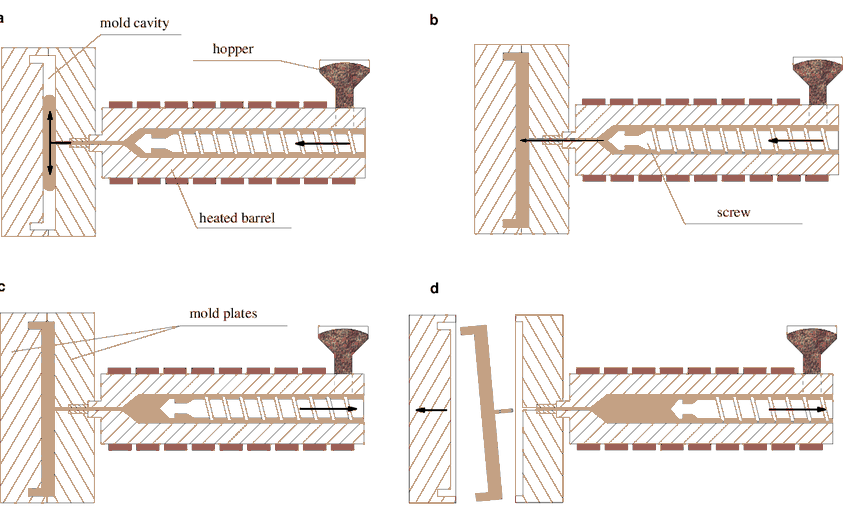

Injection Molding Cycle – Step by Step
Watch one full cycle on a machine and mold section, then change wall thickness, resin and part size to see how the cycle time changes. Hover or tap any number on the drawing.
1. Mold Close
The clamp moves the B half forward, slows down before the halves touch (mold protection), then builds full clamp force.
- Close speed: fast, then slow for mold protection
- Mold protection pressure and time
- Clamp force: ~2-8 t per cm² of projected area
Watch for: Damaged parting line if a part is left in the mold; flash if tonnage is too low.
Cooling time from tc = s² / (π²α) · ln[(4/π)(Tmelt − Tmold)/(Teject − Tmold)], with s = max wall thickness and typical resin values. Other stage times are typical estimates by part size. Real cycles depend on the mold, cooling layout and machine – use this for early budgeting only.
Quote Sign-Off and Cost Control
A 3D model can look fine on screen and still trigger surcharges for sliders or lifters. Review the print with our quoting engineers early. That strips unnecessary mold actions out before you lock the budget.
During quote preparation we audit your functional specs, dimensional tolerance standards and cosmetic requirements. Tight default tolerances on hidden internal features add machining and inspection hours. They earn you nothing commercially.
Treat early CAD files as provisional until you see our cost-reduction feedback. We document every suggested change, including parting lines, gate locations and draft tweaks. Your engineering and purchasing teams get a clear paper trail.
We never charge for surprise engineering changes mid-build. Steel cutting starts only after you sign off the final 2D/3D drawings, mold layout and fixed quote.
Prototyping to De-Risk Your Tooling

Changing a 3D print costs a few dollars. Welding and re-machining hardened steel costs thousands and weeks. A functional prototype lets your team check fit, drop resistance and heat performance before you commit to production tooling.
Once your buyers and engineers approve the prototype, we freeze the production print and book press time. Your T1 samples then match the approved spec on the first run.
Cutting Part Cost with DFM
On-time, on-budget production is decided before the CNC mill starts. Every order includes a free Design for Manufacturability (DFM) audit and a moldflow check. Here is how our DFM review works.

Fixing wall thickness, draft and rib ratios on screen prevents T1 rework loops and lowers part weight. Our plastic part design rules show how small geometry edits cut injection mold cost.
DFM Quick-Reference Parameters
| Design Feature | Recommended Value / Range | Notes |
|---|---|---|
| Wall thickness (general) | 0.8–3.0 mm | PP 1.2–3.0 mm; ABS 1.2–3.5 mm; PC 1.0–3.0 mm |
| Wall thickness variation | ±25% of nominal | Exceeding this causes differential shrinkage and warpage |
| Rib thickness | 40–60% of wall thickness | Use lower end (40%) to minimise sink marks |
| Rib height | ≤ 2.5–3 × wall thickness | Taller ribs increase ejection force requirements |
| Rib root fillet | R ≈ 0.25–0.4 × wall thickness | Reduces stress concentration |
| Draft — general outer surface | 0.5–1° | Minimum for smooth ejection |
| Draft — deep cavity inner surface | 1–2° | Increase with depth |
| Draft — textured / grain surface | 1–3° | Coarser texture requires larger angle |
| Draft — high-gloss / mirror | 0.25–0.5° | Requires excellent surface polish |
| Boss outer wall thickness | 40–60% of surrounding wall | Prevents sink marks at boss location |
| Inner fillet radius | R ≥ 0.25–0.5 × wall thickness | Larger radius for snap-fits and transparent parts |
| Cooling channel diameter | φ 8–14 mm | 8–10 mm for small/medium molds; 12–16 mm for large |
| Cooling channel centre-to-surface | 1.5–2 × channel diameter | Typically 15–20 mm for φ10 mm channels |
| Cooling channel centre-to-centre | 2–3 × channel diameter | Typically 40–60 mm |
| Sprue diameter | 4–8 mm (small/mid molds) | Large molds: 6–10 mm |
| Runner diameter | 4–7 mm (typical) | Slightly smaller than sprue |
| Pin gate diameter — small parts | 0.8–1.5 mm | GF-filled materials: increase by ~10% |
| Pin gate diameter — large parts | 1.5–2.5 mm | Adjust for viscosity of resin |
| Vent depth | 0.02–0.05 mm | Material-dependent; prevents diesel effect |
Commercial rule of thumb: Uniform walls cut both resin use and press time. If your part has a thick boss or mounting lug, gate into that heavy zone. Keep weld lines off cosmetic faces to avoid scrap.
What Sets Your Part Price

Filling → Compression / Packing → Holding Pressure → Cooling
When you buy injection molding, you pay for resin weight plus machine time. Each cycle runs through four phases. Cooling takes 50% to 70% of the clock. For worked examples, read our guide to injection molding cost per part, or run your own numbers in the cycle time calculator.
| Process Phase | Key Parameter | Typical Range |
|---|---|---|
| Filling | Injection pressure | 300–1,200 bar |
| Filling | Mold temperature (thermoplastics) | 10–120°C (up to 200°C for high-performance resins) |
| Holding pressure | Duration | Until gate freezes; process-dependent |
| Cooling | Share of total cycle | 50–70% of cycle time |
| Material shot utilisation | General resins | 20–80% of machine maximum shot |
| Material shot utilisation | Engineering resins | 30–50% of machine maximum shot |
| Cooling water temp vs. mold temp | Delta | 5–10°C below mold temperature |
| Cooling water flow rate (per circuit) | Typical | 15–30 L/min; Re ≥ 10,000 for turbulent flow |
| Mold temperature — ABS | Cavity temperature | 40–80°C |
| Mold temperature — PC | Cavity temperature | 80–110°C |
| Mold temperature — PP | Cavity temperature | 20–70°C |
| Mold temperature — PA 6/66 | Cavity temperature | 60–100°C |
Cooling time grows with the square of wall thickness. If a 2 mm wall cools in 10 seconds, a 4 mm wall takes roughly 40 seconds. Coring out thick walls and running turbulent cooling lines is the fastest way to cut your piece price.
Quality Control and Defect Prevention
High scrap rates wreck unit economics and delay containers. We do not bill you for endless sorting. Our process engineers lock a stable press window at T1, then use this matrix to remove defects at the source.
Every new part gets a T1 dimensional report. Critical dimensions are checked on CMM. Production lots are sampled to AQL ___ before packing.
| Defect | Likely Cause | First-Line Correction |
|---|---|---|
| Sink marks / voids | Wall or boss too thick; insufficient holding pressure | Reduce rib/boss thickness to 40–60% of wall; increase hold pressure and time |
| Short shot | Gate too small; excessive flow length | Open gate to 1.2–1.6 mm; add auxiliary gate for thin long-flow sections |
| Warpage | Wall thickness variation > ±25%; uneven cooling | Equalise wall thickness; balance cooling circuits; adjust holding pressure |
| Weld lines | Multiple melt fronts meeting at low temperature | Raise mold temperature; increase injection speed; vent at weld location |
| Sticking in cavity | Insufficient draft; excessive injection pressure | Add draft (min 0.5° on smooth surfaces); reduce injection-hold pressure |
| Flash | Clamping force too low; vents blocked | Check projected area vs. clamping force; clean vents; reduce injection pressure |
| Burn marks (diesel effect) | Trapped air in last-fill area | Add vents (0.02–0.05 mm depth) at fill extremities; reduce injection speed at end of fill |
For deeper diagnosis, see our injection molding defects guide, or try the interactive defect troubleshooter on our molding tools page.
Tool Ownership and Maintenance

Your mold is a capital asset. You own 100% of the tooling you pay for. When we run your production, preventive maintenance and wear-part checks are included. We log every shot and service interval, so the tool keeps making clean, flash-free parts.
Running an export mold in your own plant? Download our mold maintenance SOP for your toolroom. Matching steel grade to lifetime volume also stops you paying for H13 when P20 will do. Our mold steel and tooling standards table shows which grade fits which run.
Why Buyers Move Injection Molding to China
Price starts the conversation, but it is not the whole story. Injection molding in China works when three things line up. You need real factory pricing and a supply chain close to the press. You also need someone managing risk on your side.
Our plant sits in Huangyan, one of China's main mold and resin hubs. We buy PP, ABS, PS, PE, PVC, PC and PA at local mill prices. Mold steel, hot runners and standard parts come from suppliers a short drive away. That density keeps tool repairs and changes quick. Here is why Huangyan turns molds around faster.
| Factor | China, factory-direct | Domestic molder (US / EU) |
|---|---|---|
| Tooling price | Usually much lower for the same steel and standard | Higher labor and machining rates |
| Part price at volume | Lower resin and press-hour cost | Higher, but no ocean freight |
| Total lead time | Production plus sea or air freight | Shorter transit, often longer tool queue |
| Import duty | Depends on HS code and current tariffs | None |
| Main risk | Trading-company markup, quality drift, communication | Cost and capacity |
The risks are manageable if you know where they hide. Start with these guides:
- Buying injection molding services in China, the end-to-end playbook.
- Manufacturer vs trading company, and how to tell them apart.
- Red flags when sourcing injection moulding in China.
- Hidden costs in Chinese injection moulding, from freight to rework.
- HS code 8480.71 vs 3926.90, so molds and parts clear customs at the right rate.
- How to choose a China injection molding supplier.
Why Buyers Choose Topworks
Procurement teams sourcing plastic injection molding in China want three things: on-spec parts, quick English replies and honest landed pricing. I founded Topworks in 2006 in Huangyan, Taizhou, China's mold town. Nearly twenty years later, we still build our own molds and run our own presses.
Speed protects your launch window. Prototype parts reach your desk in about 7 days. Once a production tool is finished, T1 samples ship within 7 days, so you check fit before your competitors do.
When you compare Chinese quotes, ask who owns the CNC machines and the presses. Trading companies add 20% to 40% and hide the real factory. At Topworks, one engineering and production team runs your project from the first STEP file to FOB or DDP delivery. Want the mold and parts built to your own design? See our custom mold and molding projects.
Frequently Asked Questions
At what volume does injection molding become cost-effective?
Injection molding usually breaks even between 3,000 and 10,000 pieces, depending on part complexity and tooling cost. A simple part in a single-cavity P20 mold pays off around 3,000 units. Complex housings with multi-slide H13 tooling need 10,000+ pieces. Above 100,000 units, it gives the lowest unit price of any plastic process.
What is your MOQ for injection molded parts?
On an existing mold, MOQ is usually 500–1,000 pieces per run. For smaller quantities, our low volume and prototype molds start at around 100 parts.
Can you run production on a mold we already own?
Yes. We inspect the incoming tool, repair or refit it where needed, and run a trial before production. You keep full ownership of the mold.
How long does production take after T1 approval?
First production orders ship about 7 days after T1 sign-off. Repeat orders ship about 10 days after your PO, plus transit time.
How do you control quality on production runs?
Every new part gets a T1 dimensional report, with critical dimensions checked on CMM. Production lots are sampled to AQL ___ before packing.
What wall thickness should I design for injection molded parts?
Keep walls between 0.8 mm and 3.0 mm for most thermoplastics (PP 1.2–3.0 mm; ABS 1.2–3.5 mm; PC 1.0–3.0 mm). Keep variation within ±25% across the part. Uniform walls cool faster and use less resin, which lowers your piece price and prevents sink marks.
Do you ship worldwide, and on what terms?
Yes. We ship to the US, EU, UK, Canada, Australia and beyond on FOB, CIF or DDP terms. Standard payment is 50% deposit and 50% before shipment.
Ready to Quote Your Injection Molding Project?
Send your 3D CAD files, target volume and resin spec. Our engineers return a free DFM review and an itemized tooling and unit-price quote within 24 hours.
No drawings yet? Tell us about your part and we will help you spec it.
